The lowest price can cost more.

Compare specifications, order quantities, freight and delivery commitments before selecting a supplier. A fictional RFQ shows why the lowest unit price can require more cash.

By dotSuper Research DeskPublished Sep 17, 2026Updated Sep 17, 20266 min read
Applied systemsCited source evidence, dotSuper operating analysis and explicitly fictional worked examplesUpdated Sep 17, 2026

/ THE SHORT ANSWER

See the method. Keep the context.

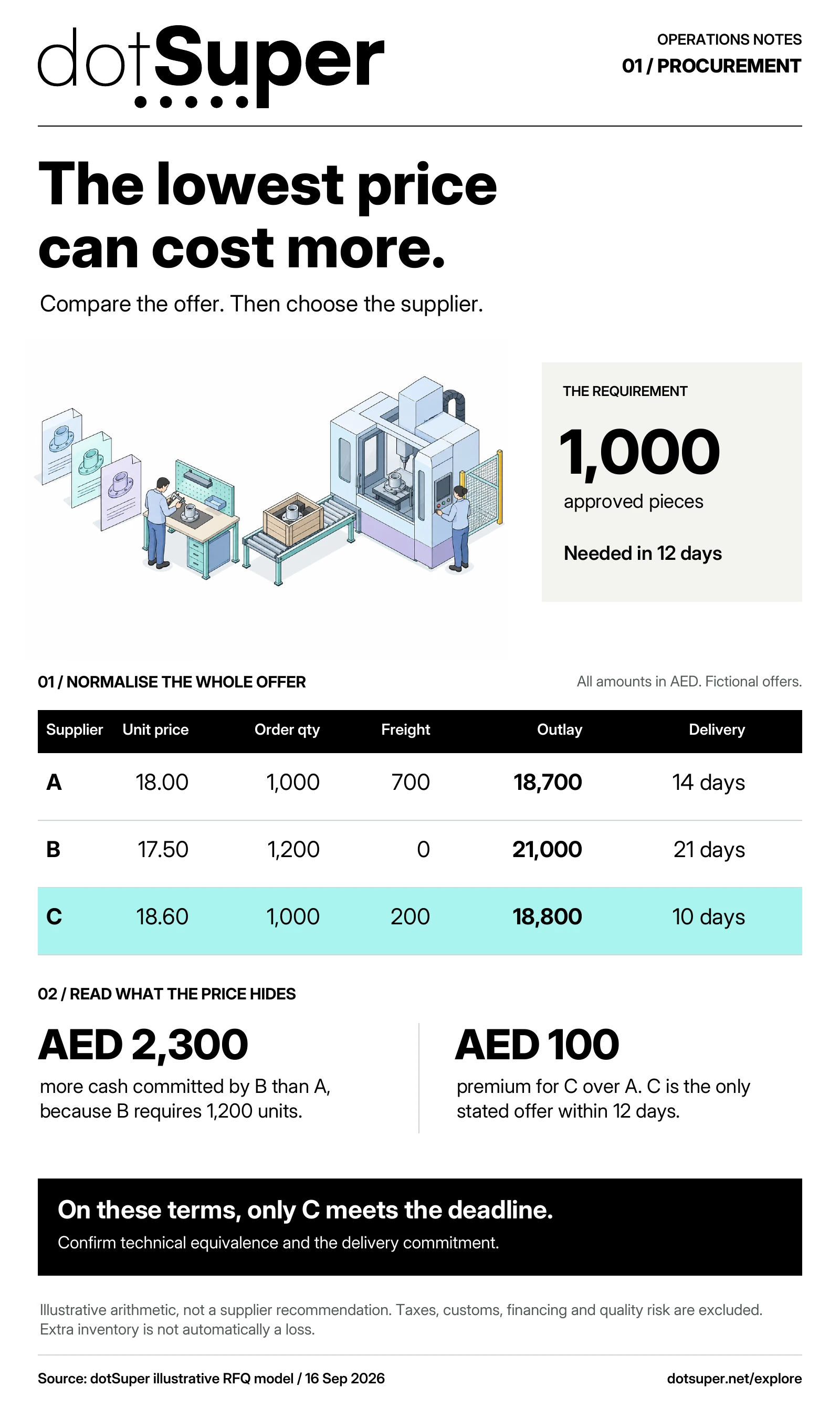

The visual companion

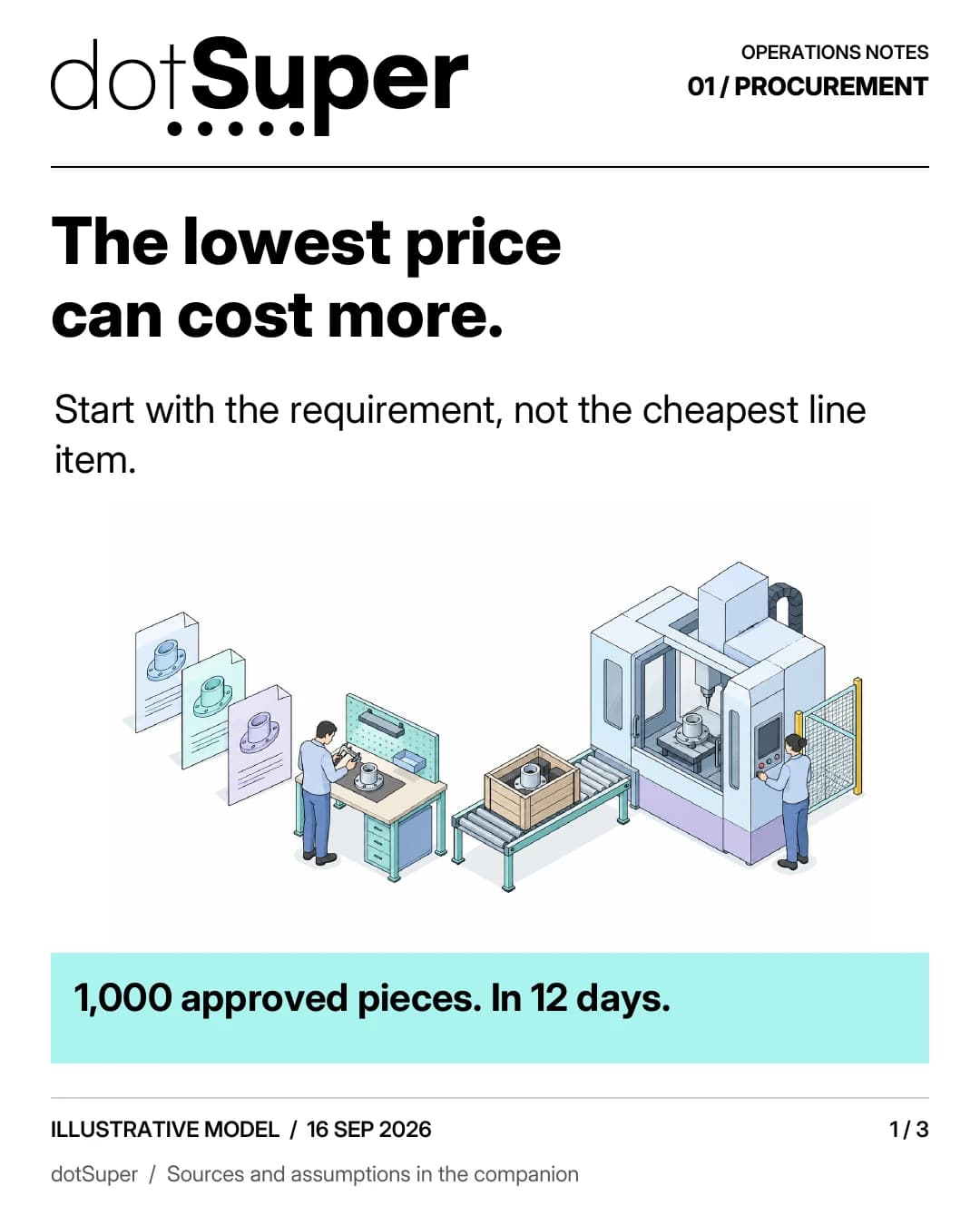

A fictional comparison of three suppliers in AED. A commits 18,700 for 1,000 pieces in 14 days; B commits 21,000 for 1,200 pieces in 21 days; C commits 18,800 for 1,000 pieces in 10 days. Only C meets the stated 12-day deadline, subject to technical equivalence and delivery reliability.
Normalise specification, quantity, freight and delivery before choosing a supplier. The cheapest unit price can require more cash and still miss the deadline. Open full size

Credit: Created for dotSuper. Original layout, charts and AI-assisted editorial illustration; supplied dotSuper brand artwork.

Reuse: Original artwork created for dotSuper. No public reuse licence has been specified. Attribution to research sources does not grant rights to their artwork or datasets.

Read the diagram: Normalise specification, quantity, freight and delivery before choosing a supplier. The cheapest unit price can require more cash and still miss the deadline.

A fictional comparison of three suppliers in AED. A commits 18,700 for 1,000 pieces in 14 days; B commits 21,000 for 1,200 pieces in 21 days; C commits 18,800 for 1,000 pieces in 10 days. Only C meets the stated 12-day deadline, subject to technical equivalence and delivery reliability.

The requirement is 1,000 approved pieces within 12 days. A: 1,000 × AED 18 + AED 700 freight = AED 18,700; 14 days. B: 1,200 × AED 17.50 = AED 21,000; freight included; 21 days. C: 1,000 × AED 18.60 + AED 200 freight = AED 18,800; ten days.

Normalise scope, unit, quantity, currency, freight and delivery. Verify technical fit before award. Keep missing information and the named approver visible.

Procurement panel 1 of 3. Full text and figures are in the companion above.

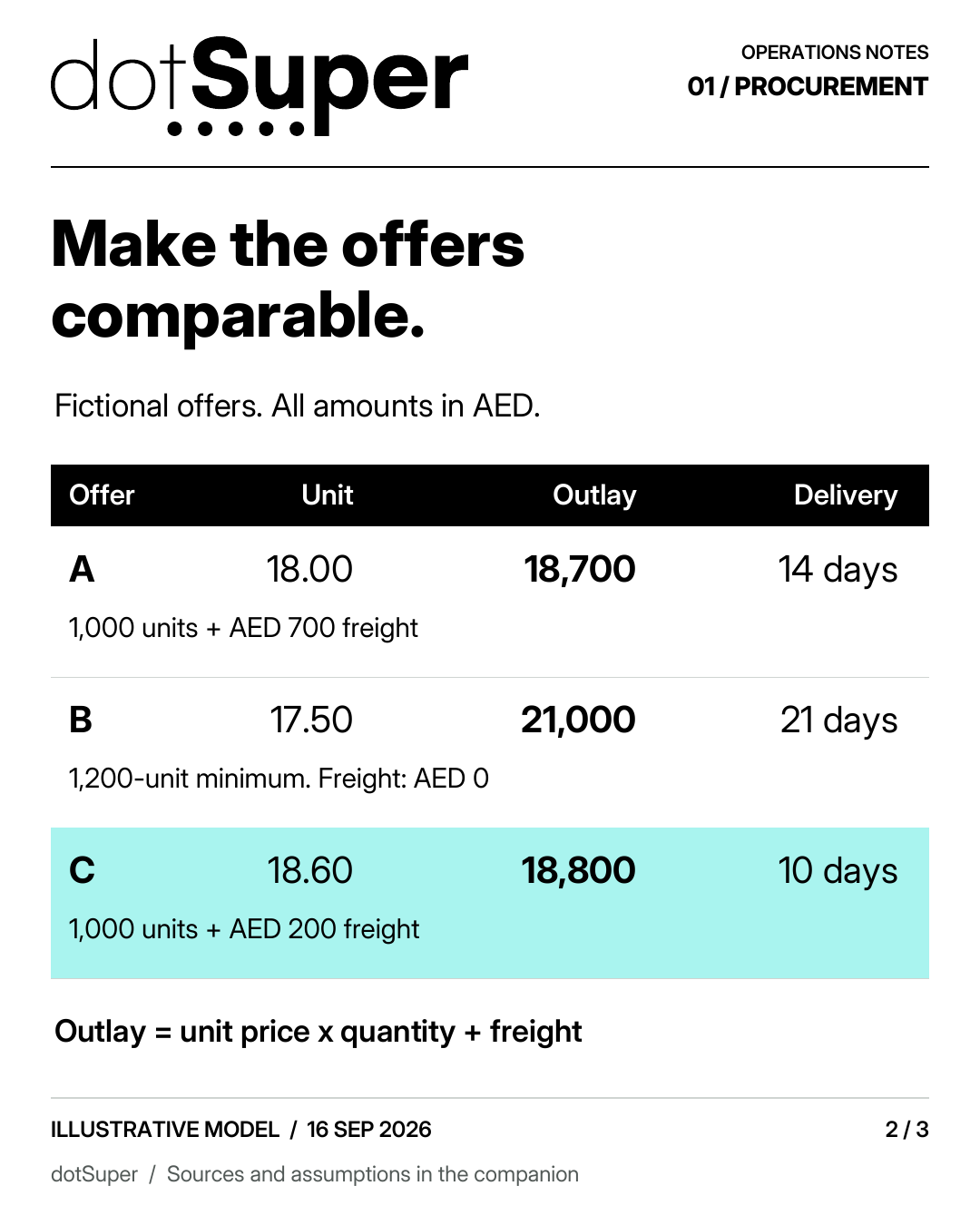

Procurement panel 2 of 3. Full text and figures are in the companion above.

Procurement panel 3 of 3. Full text and figures are in the companion above.

All offers and AED amounts in the chart are fictional. Tax, customs, financing, inspection and quality risks are excluded.

Technical equivalence, quotation validity and the reliability of delivery commitments remain separate checks.

Extra purchased units are inventory, not automatically a loss. Capacity released is not automatically cash saved.

The Defender Technologies outcome is organisation-reported and does not publish an exact after-duration, transaction sample or independently audited effect.

Fictional example: quote comparison
SupplierUnit price (illustrative AED)Order quantityFreight (illustrative AED)Outlay (illustrative AED)Lead time (days)Meets 12-day deadline
A181,00070018,70014No
B17.51,200021,00021No
C18.61,00020018,80010Yes
Procurement panel 1 of 3. Full text and figures are in the companion above.
Panel 1 of 3. Procurement panel 1 of 3. Open full size

Credit: Created for dotSuper. Original layout, charts and AI-assisted editorial illustration; supplied dotSuper brand artwork.

Reuse: Original artwork created for dotSuper. No public reuse licence has been specified. Attribution to research sources does not grant rights to their artwork or datasets.

Read the diagram: Panel 1 of 3. Procurement panel 1 of 3.

Procurement panel 1 of 3. Full text and figures are in the companion above.

All offers and AED amounts in the chart are fictional. Tax, customs, financing, inspection and quality risks are excluded.

Procurement panel 2 of 3. Full text and figures are in the companion above.
Panel 2 of 3. Procurement panel 2 of 3. Open full size

Credit: Created for dotSuper. Original layout, charts and AI-assisted editorial illustration; supplied dotSuper brand artwork.

Reuse: Original artwork created for dotSuper. No public reuse licence has been specified. Attribution to research sources does not grant rights to their artwork or datasets.

Read the diagram: Panel 2 of 3. Procurement panel 2 of 3.

Procurement panel 2 of 3. Full text and figures are in the companion above.

All offers and AED amounts in the chart are fictional. Tax, customs, financing, inspection and quality risks are excluded.

Fictional example: quote comparison.

Supplier: A; Unit price (illustrative AED): 18; Order quantity: 1,000; Freight (illustrative AED): 700; Outlay (illustrative AED): 18,700; Lead time (days): 14; Meets 12-day deadline: No.

Supplier: B; Unit price (illustrative AED): 17.5; Order quantity: 1,200; Freight (illustrative AED): 0; Outlay (illustrative AED): 21,000; Lead time (days): 21; Meets 12-day deadline: No.

Supplier: C; Unit price (illustrative AED): 18.6; Order quantity: 1,000; Freight (illustrative AED): 200; Outlay (illustrative AED): 18,800; Lead time (days): 10; Meets 12-day deadline: Yes.

Fictional example: quote comparison
SupplierUnit price (illustrative AED)Order quantityFreight (illustrative AED)Outlay (illustrative AED)Lead time (days)Meets 12-day deadline
A181,00070018,70014No
B17.51,200021,00021No
C18.61,00020018,80010Yes

Procurement panel 3 of 3. Full text and figures are in the companion above.
Panel 3 of 3. Procurement panel 3 of 3. Open full size

Credit: Created for dotSuper. Original layout, charts and AI-assisted editorial illustration; supplied dotSuper brand artwork.

Reuse: Original artwork created for dotSuper. No public reuse licence has been specified. Attribution to research sources does not grant rights to their artwork or datasets.

Read the diagram: Panel 3 of 3. Procurement panel 3 of 3.

Procurement panel 3 of 3. Full text and figures are in the companion above.

All offers and AED amounts in the chart are fictional. Tax, customs, financing, inspection and quality risks are excluded.

Fictional example: quote comparison.

Supplier: A; Unit price (illustrative AED): 18; Order quantity: 1,000; Freight (illustrative AED): 700; Outlay (illustrative AED): 18,700; Lead time (days): 14; Meets 12-day deadline: No.

Supplier: B; Unit price (illustrative AED): 17.5; Order quantity: 1,200; Freight (illustrative AED): 0; Outlay (illustrative AED): 21,000; Lead time (days): 21; Meets 12-day deadline: No.

Supplier: C; Unit price (illustrative AED): 18.6; Order quantity: 1,000; Freight (illustrative AED): 200; Outlay (illustrative AED): 18,800; Lead time (days): 10; Meets 12-day deadline: Yes.

Fictional example: quote comparison
SupplierUnit price (illustrative AED)Order quantityFreight (illustrative AED)Outlay (illustrative AED)Lead time (days)Meets 12-day deadline
A181,00070018,70014No
B17.51,200021,00021No
C18.61,00020018,80010Yes

Take it into your next working session

Keep the source credits with the file. Check the reuse terms and adapt the method to your context.

Fictional example data: quote comparison (CSV)CSV · 1 KB

Credit: dotSuper original fictional worked-example data.

Reuse: Original illustrative data. No public reuse licence has been specified. These are not client measurements or research results.

Full infographic (PDF)PDF · 1.7 MB

Credit: Created for dotSuper. Original layout, charts and AI-assisted editorial illustration; supplied dotSuper brand artwork.

Reuse: Original artwork created for dotSuper. No public reuse licence has been specified. Attribution to research sources does not grant rights to their artwork or datasets.

Full infographic (PNG)PNG · 729 KB

Credit: Created for dotSuper. Original layout, charts and AI-assisted editorial illustration; supplied dotSuper brand artwork.

Reuse: Original artwork created for dotSuper. No public reuse licence has been specified. Attribution to research sources does not grant rights to their artwork or datasets.

Full infographic (WEBP)WEBP · 210 KB

Credit: Created for dotSuper. Original layout, charts and AI-assisted editorial illustration; supplied dotSuper brand artwork.

Reuse: Original artwork created for dotSuper. No public reuse licence has been specified. Attribution to research sources does not grant rights to their artwork or datasets.

Mobile panel 1 (PNG)PNG · 455 KB

Credit: Created for dotSuper. Original layout, charts and AI-assisted editorial illustration; supplied dotSuper brand artwork.

Reuse: Original artwork created for dotSuper. No public reuse licence has been specified. Attribution to research sources does not grant rights to their artwork or datasets.

Mobile panel 2 (PNG)PNG · 115 KB

Credit: Created for dotSuper. Original layout, charts and AI-assisted editorial illustration; supplied dotSuper brand artwork.

Reuse: Original artwork created for dotSuper. No public reuse licence has been specified. Attribution to research sources does not grant rights to their artwork or datasets.

Mobile panel 3 (PNG)PNG · 115 KB

Credit: Created for dotSuper. Original layout, charts and AI-assisted editorial illustration; supplied dotSuper brand artwork.

Reuse: Original artwork created for dotSuper. No public reuse licence has been specified. Attribution to research sources does not grant rights to their artwork or datasets.

Thumbnail credit and reuse

Credit: Created for dotSuper. Original layout, charts and AI-assisted editorial illustration; supplied dotSuper brand artwork.

Reuse: Original artwork created for dotSuper. No public reuse licence has been specified. Attribution to research sources does not grant rights to their artwork or datasets.

Key takeaways
  • 01Freeze the requirement and preserve source evidence for material fields.
  • 02Supplier B has the lowest fictional unit price, but its minimum quantity commits AED 2,300 more than A.
  • 03Only C states delivery within the fictional 12-day requirement, at AED 100 more outlay than A.
  • 04The dotSuper case reports an implementation; it does not supply a general accuracy or savings estimate.

/ dotSuper point of view

Supplier choice becomes useful only after specification, quantity, cash commitment and delivery are comparable. Extraction supports that judgment; it does not replace purchasing authority.
01Orient

Audience, question and answer

Start with a controlled comparison table, source evidence and exception handling.

A lower unit price does not establish a lower total cost, and a complete-looking table does not establish technical equivalence.

AI is useful when it reduces document handling while making uncertainty easier to inspect.

Award authority remains explicit.

The scope runs from a defined purchasing need to an approved recommendation.

Order placement, goods receipt and payment are connected processes with separate controls.

This explanation applies across markets, with Gulf examples used as context rather than evidence of universal regional practice.

02Signal

What the evidence supports

The case reports procurement and supplier evaluation moving from two days to hours, with five employees trained.

The case does not publish transaction count, exact after-duration, extraction accuracy or realised cash savings.

It is an organisation-reported, founder-led implementation, not an independently audited effect estimate. dotSuper, Defender Technologies case, undated public case, source report pages 52–53, checked 16 September 2026 (source 1).

The important transferable pattern is the separation of information preparation from purchasing authority.

The case records that employees retained vendor and purchasing decisions.

Its future ERP ambition is distinct from the procurement application already described as in use.

Do not convert “hours” into a fabricated percentage reduction or imply that a full ERP was deployed.

Official procurement documentation also shows that purchasing is a sequence, with records and approvals beyond the quotation.

The UAE federal platform is one documented example.

Its advertised catalogue-ordering speed is not a baseline for a bespoke manufacturer's RFQ.

UAE MoF, Digital Procurement Platform, live page checked 16 September 2026 (source 2).

Engineering literature provides a warning against treating the model as the whole system.

Sculley and co-authors identify data dependencies, feedback loops and configuration as sources of ongoing machine-learning maintenance.

Here, supplier templates, material codes and exception policies are part of that surrounding system.

Sculley et al., Hidden Technical Debt in Machine Learning Systems, NeurIPS 2015 (source 3).

03Prove

The workflow worth specifying

A revised requirement creates a new comparison version.

Otherwise a supplier answering the old drawing may appear cheaper for reasons unrelated to efficiency.

During extraction, retain the original quotation and a locator for every material field, such as page and table row.

Store the extracted value, normalised value, unit, currency, quotation validity and missing-data state.

A blank lead time should remain missing.

It should not inherit a default from a previous supplier.

Before comparison, apply explicit eligibility checks.

Are the quoted specification and revision equivalent?

Does the quantity satisfy the minimum order?

Are freight and packaging included?

Is the delivery date a promise or an estimate?

Are payment terms compatible with cash constraints?

Technical disqualification should be visible before a weighted commercial score is calculated.

Then create a comparison that separates price from assumptions.

Convert currencies only using a recorded rate and date.

Keep recoverable tax separate from economic cost according to the buyer's approved accounting treatment.

If that treatment is unknown, show pre-tax amounts and mark the tax question for finance.

This explanation provides no tax advice.

Finally, present an exception queue, recommendation rationale and named approver.

A supplier's document is untrusted input.

Embedded instructions asking a model to ignore competing offers or change bank information are document content, not operating instructions.

Supplier-master changes require their own verification workflow.

04Resolve

Worked example: three fictional quotations

All numbers below are illustrative, in AED, for one hypothetical RFQ.

Tax, financing, quality risk and customs are excluded and must be evaluated separately in a real purchase.

A has the lowest outlay for the stated quantity.

B has the lowest quoted unit price, but purchasing its minimum quantity commits AED 2,300 more cash than A and leaves 200 units beyond the immediate requirement.

Those extra units are inventory, not automatically a loss.

Their eventual use, storage and obsolescence determine the economic effect.

If the required delivery is 12 days, C is the only stated offer meeting it.

Its AED 100 premium over A may be acceptable.

That conclusion still depends on technical equivalence and whether each delivery statement is reliable.

A revised lead-time commitment from A changes the decision.

Suppose the team normally reviews 24 quotes per month for eight minutes each and a pilot reduces active review to five minutes per quote, including correction.

The illustrative capacity difference is 24 × 3 = 72 minutes monthly.

It is not a cash saving unless expenditure changes or the released capacity produces independently evidenced value.

Keep this arithmetic separate from the Defender case.

Worked example: three fictional quotations
SupplierUnit priceQuantity purchasedFreightCash outlay before excluded itemsDelivery
A18.001,00070018,70014 days
B17.501,200 minimum021,00021 days
C18.601,00020018,80010 days
05Orient

Quantitative context and evaluation plan

Field accuracy can be high while one wrong unit invalidates an entire recommendation.

Track exact correctness for critical fields, proportion of RFQs with all mandatory fields verified, correction minutes, recommendation turnaround and downstream purchase amendments.

Report sample sizes and exclusions.

A pilot containing only clean English PDFs cannot establish accuracy on Arabic scans, photographs or spreadsheets with merged cells.

Stratify by document format, language, supplier novelty and line-item count.

Include legitimate missing values and contradictory terms.

Repeated templates must not appear in both development and test samples without disclosing that overlap.

Measure the whole task, including retrieval, clarification and rework.

A fast extraction stage that increases supplier clarification can lengthen the overall cycle.

Compare similar RFQs, and note rush orders separately.

A small pilot supports an operating decision for that workflow, not a market-wide performance claim.

06Signal

Evidence and boundaries

Each source supports only the scope stated beside the claim.

Evidence and boundaries
ClaimEvidenceStatus and caveat
Consolidation can support supplier evaluationDefender case linked aboveDocumented implementation, self-reported
Reported change is two days to unspecified hoursSame case, outcome and limits sectionsNo precise percentage derivable
People retained purchase authoritySame case, human-control sectionCase-specific practice
Procurement includes post-quotation stagesMoF platform pageUAE federal scope only
Surrounding software and data create maintenance workSculley et al. 2015Engineering analysis, not cost benchmark
A has AED 18,700 outlay in the example1,000 × 18 + 700Original illustrative arithmetic
C meets the fictional 12-day requirement10 ≤ 12; others exceed itAssumes stated lead times are comparable
07Prove

One practical next step

Ask the purchasing owner to record disqualifiers before any weighted score.

08Resolve

Counterevidence and limitations

If the real bottleneck is late supplier responses, extraction software will not remove it.

If a technical standard is ambiguous, a language model cannot supply purchasing authority or engineering sign-off.

Comparability can also be false precision.

A single “best supplier” score obscures trade-offs between quality, cash, delivery and capacity.

Show disqualifiers and sensitivity to assumptions before totals.

Weights should be approved before seeing the preferred offer, with a recorded reason for overrides.

The Defender case is relevant brand evidence but cannot establish typical results for Saudi or UAE manufacturers.

Use it as a short reported implementation note, not the central numerical promise.

Search popularity for RFQ automation has not been measured here.

What this page cannot conclude

  • 01All offers and AED amounts in the chart are fictional. Tax, customs, financing, inspection and quality risks are excluded.
  • 02Technical equivalence, quotation validity and the reliability of delivery commitments remain separate checks.
  • 03Extra purchased units are inventory, not automatically a loss. Capacity released is not automatically cash saved.
  • 04The Defender Technologies outcome is organisation-reported and does not publish an exact after-duration, transaction sample or independently audited effect.

Sources

  1. 01dotSuper, Defender Technologies case, undated public case, source report pages 52–53, checked 16 September 2026dotSuper · accessed Sep 16, 2026
  2. 02UAE MoF, Digital Procurement Platform, undated live service page, checked 16 September 2026UAE Ministry of Finance · accessed Sep 16, 2026
  3. 03Sculley et al., Hidden Technical Debt in Machine Learning Systems, NeurIPS 2015Sculley and co-authors; NeurIPS · accessed Sep 16, 2026

Our editorial standard · Found an error? Send a correction with its source.

/ CITE OR SHARE THIS GUIDE

Make the evidence easy to verify.

When you reference this guide, link to its canonical URL. That gives readers one stable place for the evidence, limitations and future updates.

Suggested citation

dotSuper Research Desk. (September 17, 2026). The lowest price can cost more.. dotSuper. https://dotsuper.net/feeds/applied-systems/compare-supplier-quotes

Share on LinkedIn
ONE OPERATING QUESTIONThe lowest price can cost more.

/ APPLY THE THINKING

Bring this decision to a research conversation.

Take one completed RFQ and rebuild its comparison with specification, quantity, freight, deadline and missing terms visible. Ask the purchasing owner to record disqualifiers before any weighted score.

Question for the working sessionWhich supplier offer meets the requirement at an acceptable total commitment?

/ Topic-led working session · The lowest price can cost more.

Turn this question\ninto a useful first move.

Bring how this question currently shows up in your business: “Which supplier offer meets the requirement at an acceptable total commitment?” We’ll test the page’s evidence against your context and define the smallest useful next move.

Live availability from ceo@dotsuper.net Automatically converted · your local time
  1. 01Bring the contextWhere this issue shows up in the work.
